Armor One

The Armor One project is a major U.S. Army Corps of Engineers (USACE) initiative aimed at modernizing river revetment operations on the Lower Mississippi River and its tributaries. It replaces the aging Mat Sinking Unit (MSU), a nearly 70-year-old system used to install concrete mats on riverbeds to prevent bank erosion and flooding. By integrating advanced robotics and automation, the project enhances safety, efficiency, and production capacity for flood protection infrastructure.

Robotic Automation

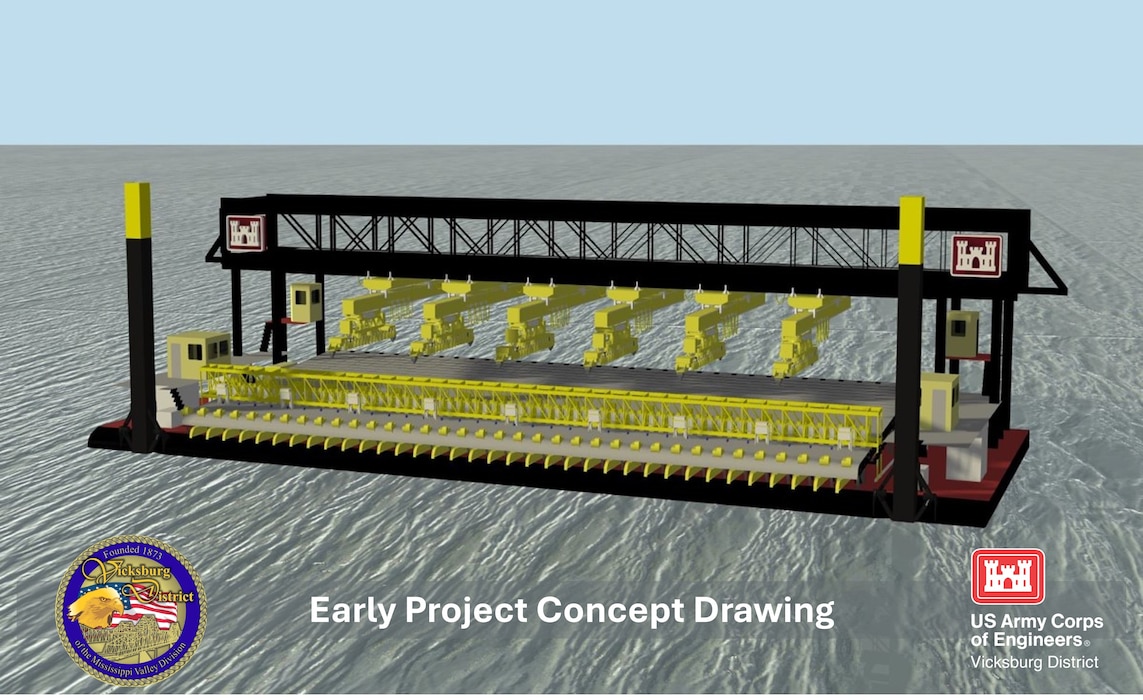

At its core, Armor One features the world's largest mobile robot, equipped with six robotic arms, perception systems, and automated tie gantries to precisely place and secure mats. This allows for a production rate of up to 4,000 square yards (or "ACM squares") per day—more than double the MSU's capacity.

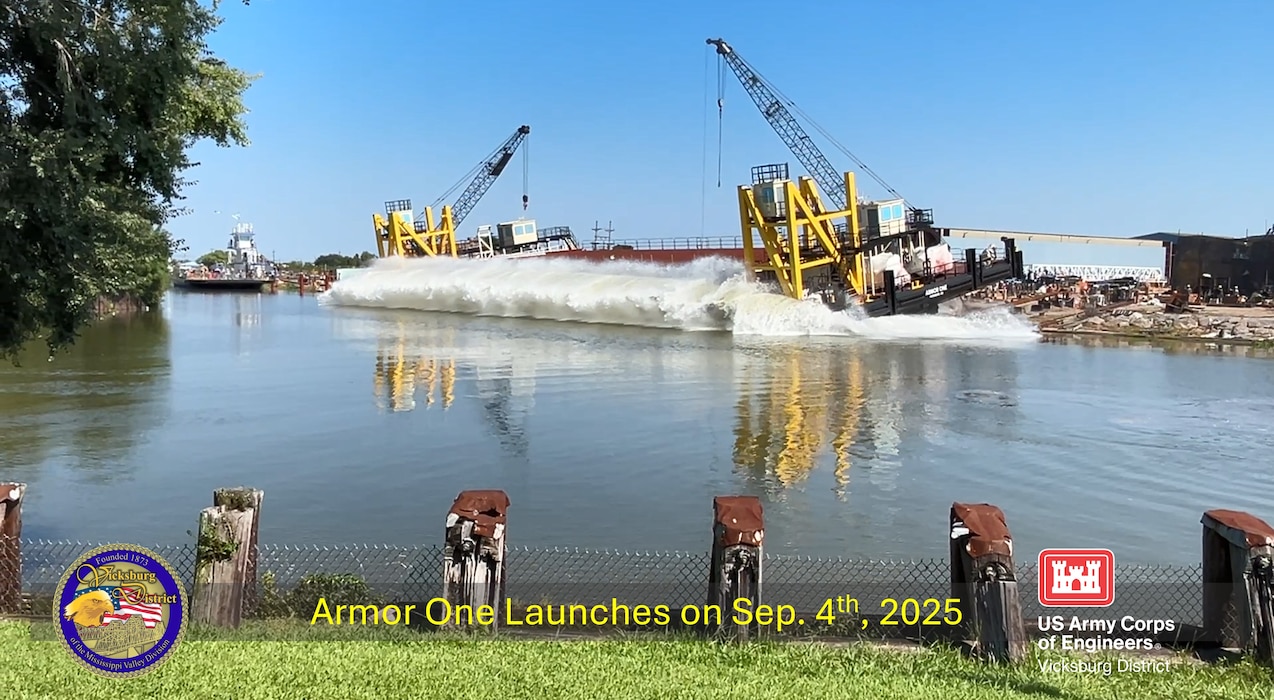

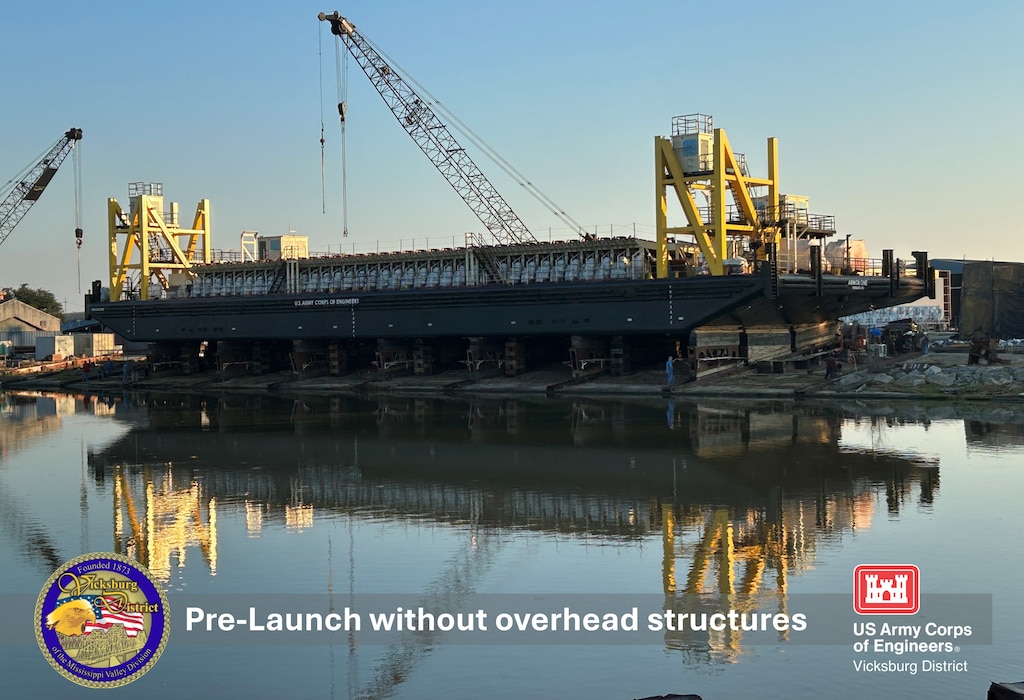

Barge Design: The system is housed on a custom-built barge, launched on September 4, 2025, by Thoma-Sea Marine Constructors in Lockport, Louisiana. It includes an active deck roller system for aligning mat components and improved manual tie tools for hybrid operations.

Safety and Efficiency Gains
Automation reduces worker exposure to dangerous tasks, such as handling heavy loads in dynamic river environments, while simulators and prototypes ensure reliable performance.

Development and Partnerships
The project originated from a "from-scratch" design process starting around 2019, involving extensive prototyping and testing. Key partners include:

  • USACE Vicksburg District: Leads the effort, coordinating construction and river testing.
  • National Robotics Engineering Center (NREC) at Carnegie Mellon University: Developed the robotics software and hardware, including full-scale simulators.
  • Salas O'Brien: Provides engineering and integration support.
  • Bristol Harbor Group: Handled marine design.
  • ABS Group: Ensured compliance and safety standards.
  • Hinds Community College: Offers workforce training for operating the new systems.

Construction is underway at Thoma-Sea's Louisiana shipyard, with robotics installation and on-site testing planned next, followed by full-scale trials on the Mississippi River.

Current Status (as of September 25, 2025)
Just weeks after the barge launch, the project is in the implementation phase, focusing on validation and integration. This timely upgrade supports ongoing revetment missions critical for navigation safety and flood control in the Mississippi Valley.
Armor One represents a blend of traditional civil engineering with cutting-edge robotics, ensuring long-term resilience against erosion while prioritizing human safety. For more details, visit the USACE Vicksburg District resources.

Mission History

Controlling the Mighty Mississippi River

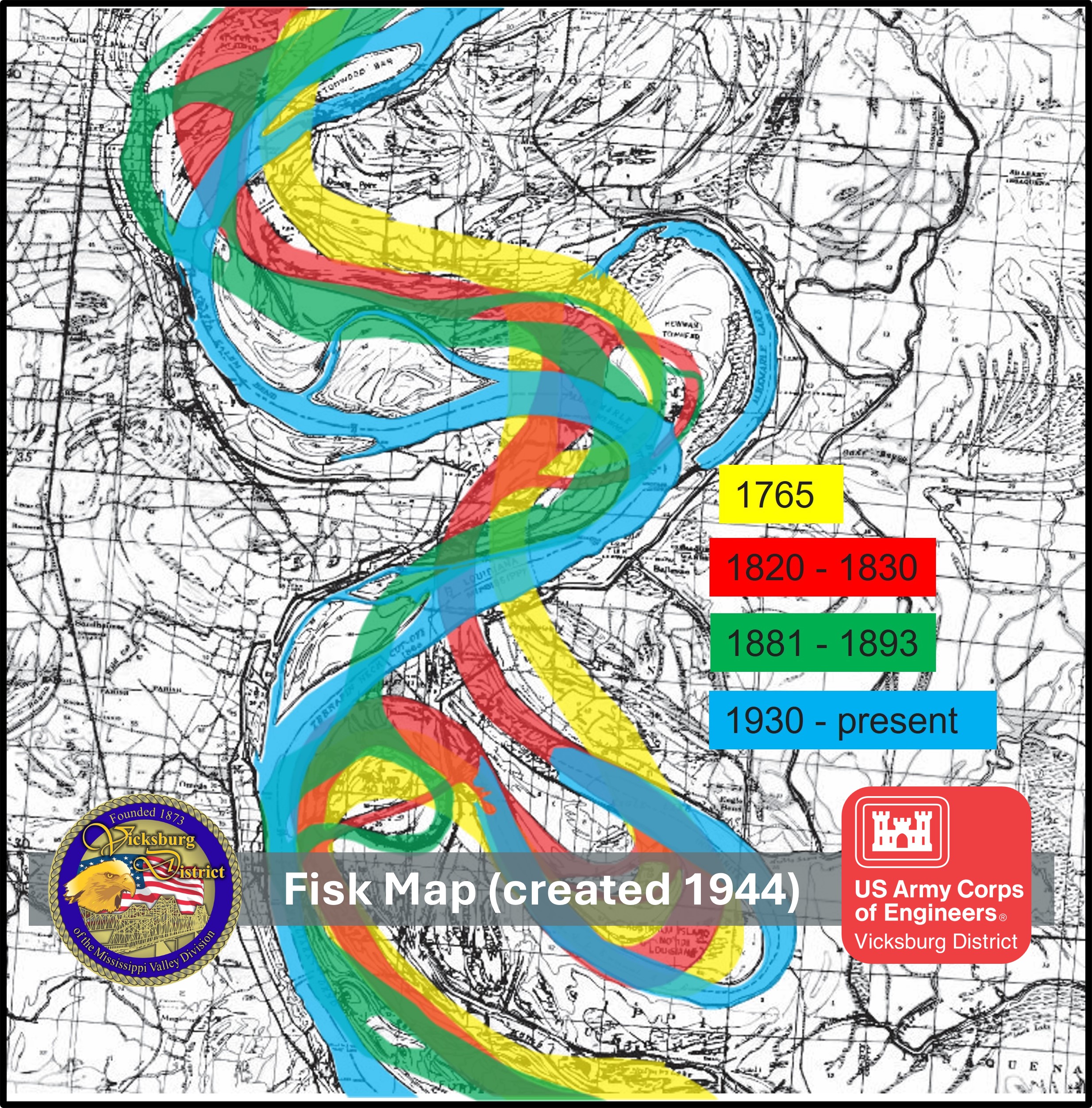

This is a portion of a Fisk Map and it was created by Harold N. Fisk, a geologist and cartographer, in 1944 as part of his report Geological Investigation of the Alluvial Valley of the Lower Mississippi River for the U.S. Army Corps of Engineers. This map illustrates the historical meandering paths of the lower Mississippi River over a span of years, showing how the river's channel has shifted within its broad alluvial valley or "meander belt."

Each color represents a span of time and the locations of the Mississippi River channel. Without armoring, the River is a constantly meandering force capable of:

  • Cutting a new channel
  • Breaching a levee system
  • Destroying property and threatening populations
  • Interrupting navigation and commerce
  • Disrupting agricultural production
  • Endangering natural habitats

The Solution

Revetment efforts on the Mississippi River began in earnest in the early 20th century following devastating floods in the 1920s and 1930s. The MSU was established to lay interlocking concrete mats—each about 15 feet wide and 100 feet long—along vulnerable riverbanks to stabilize sediment and reduce scour.

Over decades, this manual process has protected critical navigation channels but relies on labor-intensive methods prone to hazards like heavy machinery operation and river currents. The Armor One project addresses these limitations through technological upgrades.

Laying mattresses traces it's roots to 16th-century Europe, particularly the Netherlands, where hydraulic engineering was critical for managing floods, canals, and dikes in a low-lying, waterlogged landscape. They were documented as early as the 1500s in Dutch river and coastal works,

Early mats were constructed of willow or lumber framework mattresses that were wired together to form protective structures that were then placed on a graded slope.

Mattresses were backfilled with silt and armored with rock. ACM was apparently invented and patented in 1914/1916. MVK sank the first ACM in 1917.  It's configuration and placement methods were continually modified until the 1940's.

The organized high productive method that is used today was "put together" right after WWII. The mat boat the Vicksburg District had until the '90's was actually constructed in 1926. After the consolidation, Vicksburg received Memphis District's mat boat and it's keel was laid in 1948.

A stable channel is more efficient in moving high river stages while also reducing bank caving. As a result, levees, which are critical to the protection of a city such as New Orleans are far less likely to be compromised when they are most needed.
